PM Deferral Management Software: Approval Workflow

By Corin Hale on October 12, 2026

pm-deferral-management-software-approval-workflow

Every facility team defers preventive maintenance at some point. A shutdown window is cancelled, a contractor misses a date, or a production push makes a lockout impossible. The deferral itself is rarely the problem. The problem is the postponement nobody approved, nobody time-limited, and nobody can explain to an auditor months later. This guide walks through a practical PM deferral approval workflow, the reason codes and approval tiers that hold up in review, and how maintenance management software like Oxmaint keeps every postponement documented.

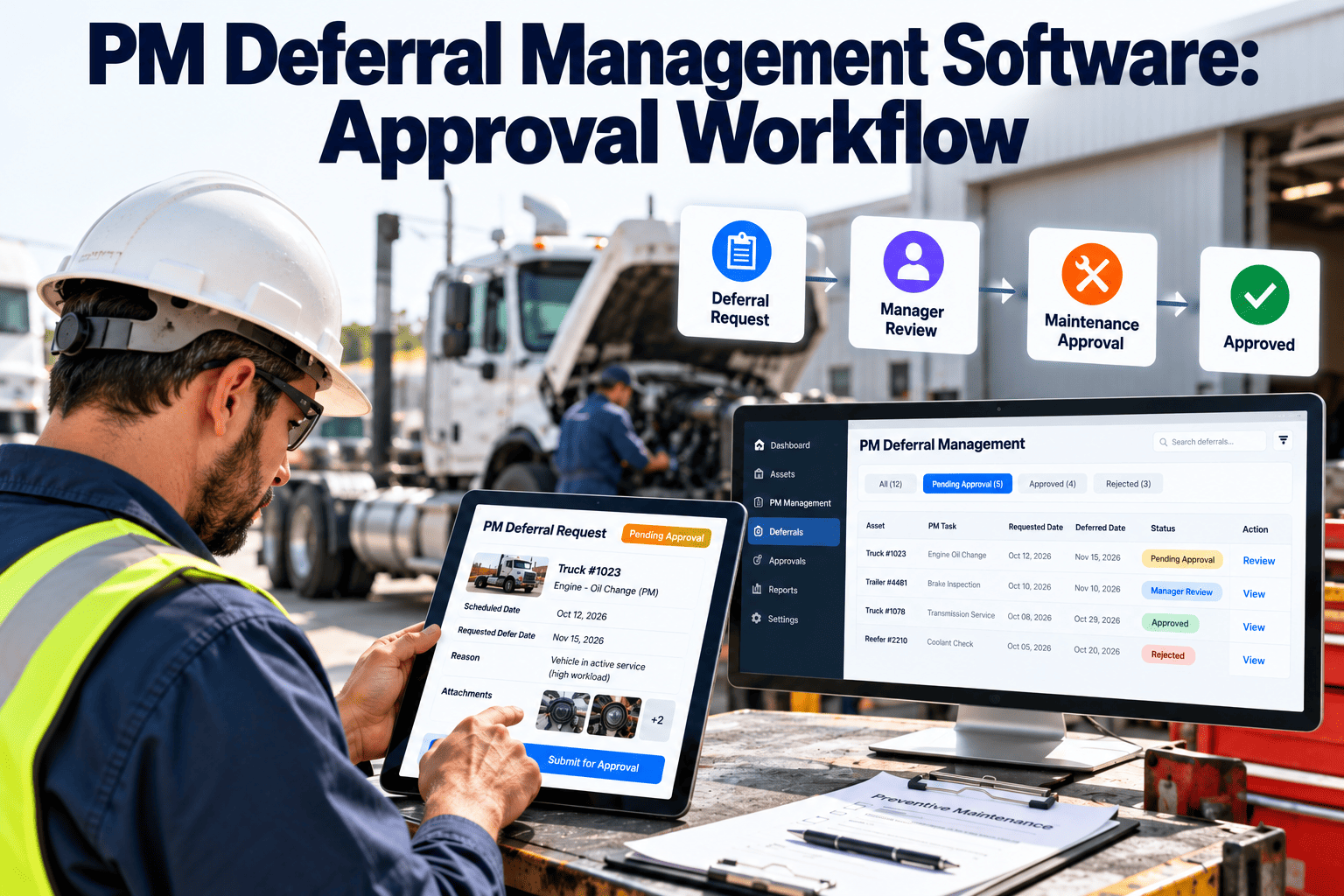

PM Deferral ManagementFacility Approval Workflow

PM Deferral Management Software: An Approval Workflow That Survives an Audit

Replace quiet PM slippage with a controlled request, risk check, approval, expiry date, and reschedule trail for every deferred task across your facilities.

1RequestReason code, asset, requested new date
2Risk checkCriticality, compliance flag, history
3ApprovalTiered approver with an expiry date
4Close-outRescheduled work order and audit trail
Definition

A Deferral Is a Decision With an Owner and an Expiry Date

Many teams treat "pushed to next month" as a scheduling detail. In a controlled program, a deferral is a recorded risk decision: who asked, why, what could go wrong, who accepted that risk, and when the task must be done.

The quiet slip

  • The due date is edited and the original date disappears
  • The reason lives in a text message or someone's memory
  • No one with authority saw the request
  • The same PM slides again the following month
  • An auditor finds a gap and no explanation

The controlled deferral

  • The original due date stays on the record
  • A reason code and written justification are required
  • The approver matches the asset's criticality
  • A hard expiry date pulls the task back into the schedule
  • Reports show every deferral, approver, and outcome
Compliance Lane

PM Tasks That Should Never Enter the Normal Deferral Queue

Not every PM belongs in the same approval path. Tasks tied to codes, insurers, or an authority having jurisdiction carry fixed intervals that an area supervisor cannot extend alone.

Task TypeTypical Governing SourceRoute Change Requests To
Fire sprinkler and alarm inspection, testing, maintenanceNFPA 25, NFPA 72, local fire codeLife safety owner and fire authority as required
Emergency generator testingNFPA 110, facility accreditation rulesElectrical authority and compliance manager
Elevator and escalator inspectionLocal jurisdiction, ASME A17.1 practiceCompliance manager and service contractor
Boiler and pressure vessel inspectionJurisdictional inspection rules, insurer requirementsCompliance manager and insurer contact
Backflow preventer testingLocal water authorityPlumbing lead and compliance manager
Lockout/tagout procedure inspectionOSHA 29 CFR 1910.147 periodic inspectionSafety manager

A good workflow detects these tasks through a compliance flag on the PM template. Any deferral request on a flagged task skips the normal tiers and goes straight to the compliance owner.

Reason Codes

Reason Codes Turn Free-Text Excuses Into Reportable Data

Free-text reasons cannot be trended. A short, controlled list lets you see whether deferrals come from parts, access, labor, or planning failures. The codes below are example starting points to adapt to your policy.

CodeTypical SituationEvidence To AttachExample Window
Production ConstraintAsset cannot be taken offline during a runProduction schedule or operations sign-offUntil next planned stop
Parts UnavailableFilters, belts, or seals are on orderPurchase order and expected receipt dateUntil parts receipt plus one week
Labor ShortageQualified technician is not availableStaffing note and backfill planShort, with weekly review
Access RestrictionArea closed, tenant event, or weatherFacility notice or access requestUntil access reopens
Contractor DelayVendor missed the booked visitVendor confirmation of new dateUntil confirmed visit
Asset RetirementEquipment scheduled for replacementCapital project or decommission recordReview at each interval
Justification

Writing a Deferral Justification That Holds Up in Review

A reason code explains the category. The written justification explains the decision. Reviewers and auditors read it to judge whether the risk was understood, so it should make sense even if its author has left the company.

Weak justification

"Too busy this week, will do later." There is no asset impact, no new date, no risk statement, and no interim safeguard. A reviewer cannot tell whether the task is a filter change or a fire pump test.

Strong justification

"Chiller 2 quarterly inspection deferred because tenant event access restrictions close the plant room through Friday. New date is the following Tuesday. Weekly temperature and pressure readings added as interim checks. The last inspection found no defects."

Six elements every justification should contain

  • The exact asset and task. Name the equipment and the specific PM, not just the building.
  • What prevented the work. State the real constraint in plain words.
  • The new date. A named date, never "when possible".
  • The risk if it slips again. Describe the likely failure and its consequence.
  • The interim safeguard. List the lighter check that covers the gap.
  • Supporting evidence. Attach the order confirmation, notice, or schedule that backs the reason.
Approval Tiers

Match the Approver to Asset Criticality and Deferral Length

A single approver for everything either creates a bottleneck or a rubber stamp. Tiering by asset criticality and by how long the task is postponed keeps routine requests fast and serious requests visible.

Asset CriticalityWithin Grace WindowUp To One Full IntervalBeyond One Interval
Critical or life safetyMaintenance managerFacility director and risk ownerNot permitted without executive review
Important to operationsSupervisorMaintenance managerFacility director
Standard building systemsSupervisorSupervisor with noteMaintenance manager
Low consequencePlannerSupervisorMaintenance manager
Workflow

The Five Stages of a Defensible PM Deferral

  1. 01

    Raise the request from the work order

    The planner or technician selects a reason code, enters the proposed new date, and writes the justification against the exact asset and task.
  2. 02

    Run the risk check

    The system surfaces criticality, compliance flag, last completion date, and how many times this task was already deferred.
  3. 03

    Route to the correct approver

    The tier table decides who sees it. Approvers can approve, reject, or approve with conditions such as compensating checks.
  4. 04

    Set the expiry and compensating actions

    Approval always carries a hard expiry date. Any interim inspection or monitoring task becomes its own scheduled work order.
  5. 05

    Reschedule, complete, and close the loop

    The deferred PM returns to the schedule, is completed, and the deferral record is closed with the actual completion date.
Scenarios

Four Deferral Situations and How the Workflow Responds

Policies look simple until a real request arrives. Walking through typical situations shows where tiering, the compliance lane, and compensating controls each earn their place.

SituationClassificationApproval PathConditions Attached
Air handler filter change delayed by a back-ordered partStandard asset, parts reasonSupervisor approves a short deferralOrder confirmation attached, weekly pressure check, expiry one week after parts arrive
Fire pump test falls during a tenant eventLife safety, compliance flaggedCompliance owner decides, not the area supervisorReschedule to the earliest permitted window and notify the authority where required
Cooling tower inspection pushed three times in a rowRepeat deferral on an important assetEscalates automatically to the maintenance managerReview the root cause: staffing, access, or an unrealistic task definition
Roof drain cleaning deferred as storm season approachesSeasonal task with rising consequenceManager approval with a firm date before forecast weatherPost-rain inspection added and drain photos recorded

Stop Explaining Missed PMs From Memory

Give planners a structured request, give managers a clear approval queue, and give auditors a record that answers its own questions.
Risk Control

Compensating Controls: What Happens While the PM Waits

Approving a deferral without adding a safeguard simply accepts more risk. Each deferred task should trigger a lighter interim check aimed at the failure the PM was meant to prevent.

If deferred
Air handler filter change
Then add
Differential pressure reading and visual check each week
If deferred
Bearing lubrication on a pump
Then add
Temperature and vibration spot readings on a short route
If deferred
Belt inspection on a fan
Then add
Operator walk-down for noise, tracking, and slip
If deferred
Roof drain cleaning before storm season
Then add
Post-rain inspection and photo record of drain areas
Measurement

Six Metrics That Show Whether Deferral Is Under Control

Deferral rate
Deferred PMs divided by scheduled PMs
Trend by site, craft, and asset class to see where planning breaks down.
Expired deferrals
Approved deferrals past their expiry date
This should be close to zero. Any number above it means the safeguard is failing.
Repeat deferral count
Times one task has been deferred in a row
Reveals assets whose PM is unrealistic, under-resourced, or unnecessary.
Average deferral age
Days between original due date and completion
Shows whether deferrals are short delays or becoming permanent.
Compliance PM deferrals
Deferrals on flagged regulatory tasks
Track every one and review each with the compliance owner.
Compensating action completion
Interim checks completed divided by interim checks assigned
Confirms the safeguards promised at approval were actually performed.
Responsibilities

Who Does What in a Deferral Workflow

Deferral control fails when everyone assumes someone else is watching. Clear roles keep the request, the decision, and the follow-through with named people.

Technician

Flags the problem early, records what was observed, and completes any interim checks assigned at approval.

Planner

Prepares the request, confirms the new date, and lines up parts, labor, and access for the rescheduled task.

Approver

Reviews the risk, adds conditions, or rejects the request. Never approves what they cannot assess.

Compliance owner

Owns regulated tasks, authority communication, and the final decision on any deferral touching a code interval.
Aging

Deferral Aging: Escalate Before the Backlog Becomes Normal

Aging buckets give supervisors a daily view of how far past the original due date each deferred task has drifted, and what should happen next.

0 to 7 days past original date

Supervisor confirms new date
8 to 30 days past

Maintenance manager reviews
31 to 90 days past

Facility director and risk review
Over 90 days past

Re-baseline the PM or retire the task
Software Selection

What to Require From PM Deferral Management Software

When comparing CMMS platforms for deferral control, test the approval path with a real scenario rather than a feature list. These requirements separate record-keeping from true control.

  • Original due date preserved. Edits never overwrite history.
  • Mandatory reason code and justification. The request cannot be submitted blank.
  • Criticality-based routing. Approvers change with asset class and deferral length.
  • Compliance flag. Regulated tasks follow a separate path.
  • Hard expiry with escalation. Expired approvals notify managers automatically.
  • Mobile approval. Managers can approve from the floor, not only a desktop.
  • Reporting by reason, site, and approver. Export-ready for audits and reviews.
Policy

Six Elements of a Written PM Deferral Policy

Software enforces a policy; it cannot invent one. Document these elements first, then configure the workflow to match.

Scope
Which tasks, assets, and sites
Prevents informal side agreements between individual supervisors.
Grace window
How far past due a task may run
Avoids paperwork for trivial slips while keeping long delays visible.
Reason codes
Controlled list with evidence rules
Makes deferral causes reportable and comparable across sites.
Approval matrix
Approver by criticality and length
Keeps routine requests fast and serious requests visible to leadership.
Expiry and escalation
Hard dates and who is notified
Stops approved deferrals from becoming permanent by default.
Review cadence
Monthly open list, quarterly trends
Turns individual decisions into lessons about planning and resources.
Pitfalls

Mistakes That Turn a Deferral Process Into Paperwork

  • Approving everything at one level. A single approver becomes either a bottleneck or a rubber stamp.
  • Allowing open-ended approvals. A deferral without an expiry is simply a cancelled PM.
  • Ignoring repeat deferrals. The fifth request for the same task signals a planning problem, not a scheduling one.
  • Skipping compensating checks. Approval without an interim safeguard just accepts more risk.
  • Treating compliance tasks like routine ones. Regulated intervals need their own path and owner.
  • Never reviewing the data. Reason codes only help if someone reads the trend every month.
Audit Readiness

What to Be Able to Produce on Audit Day

  • A list of every deferral in the period. Filter by site, asset class, reason code, and approver.
  • The full record for any single deferral. Original date, request, evidence, approval, expiry, and completion.
  • Proof that regulated tasks were never extended internally. Show the compliance path and decision owner.
  • Evidence that interim checks were done. Completed work orders matched to each approval.
  • Trend data showing management attention. Monthly review notes and actions taken on repeat deferrals.
Oxmaint Platform

How Oxmaint Supports a Controlled Deferral Workflow

Oxmaint connects asset records, preventive maintenance scheduling, work orders, and reporting in one system, which is the foundation a deferral process depends on.

Asset records

Criticality and maintenance history stay attached to each asset for the risk check.

PM scheduling

Recurring tasks generate work orders that planners can review and reschedule with context.

Work orders and notes

Justification, evidence, and interim inspections are recorded against the same task.

Mobile and reporting

Technicians and managers act from the field while dashboards show open and overdue PM.
FAQ

PM Deferral Questions Facility Teams Ask

What is a PM deferral?

It is an approved, documented postponement of a scheduled preventive task. See how Oxmaint scheduling keeps the original date on record.

Who should approve a PM deferral?

Approval should scale with asset criticality and deferral length, with compliance tasks routed to the compliance owner.

How long can a PM be deferred?

Set a grace window per task and require a hard expiry on every approval. Regulatory intervals set by code or an authority are not yours to extend.

What should an auditor see for a deferred PM?

The original due date, reason, approver, expiry, compensating checks, and completion. Book a demo to review that record in Oxmaint.

How do we reduce repeat deferrals?

Trend reason codes, fix the underlying cause such as parts or staffing, and re-baseline PM tasks that are repeatedly pushed.

Make Every Deferred PM Defensible

Bring request, approval, expiry, and completion into one maintenance system, so the next audit question already has an answer on file.
